yes it will be once the reusable Europan rocket is readyI wonder if there ever will an Ariane 7?
Ariane 6 is dead,
and since NESTS not pronounceable, they will called it Ariane 7...
yes it will be once the reusable Europan rocket is readyI wonder if there ever will an Ariane 7?
Well it could compete on price only a mere decade ago (given some subsidies).It’s interesting to hear that they literally chose keeping certain countries onboard over efficiency of production, shows you that Ariane is still as much a political project as an engineering one, and why it will never truly compete on price. Also the fact that the upper stage of Ariane 5 could not restart its upper stage in orbit added a year’s journey time to Juice.
Also the fact that the upper stage of Ariane 5 could not restart its upper stage in orbit added a year’s journey time to Juice.
Because it never was supposed to be a long term solution, ESC-A was initially only a stopgap for the Vinci-powered ESC-B, which is why it reused the engine and oxygen tank of Ariane 4’s upper stage, and why it doesn’t have restart capabilities, and a worse mass fraction than even the Chinese and Indian cryogenic stagesI was very surprised to learn that the second-stage couldn't be restarted, that was an extremely shortsighted design decision.
I asked on NSF & apparently the plan was for ESC-A to be an interim solution only, pending the development of ESC-B using the restartable Vinci engine. That was cancelled, IIRC after the failure of the first ECA launch.I was very surprised to learn that the second-stage couldn't be restarted, that was an extremely shortsighted design decision.

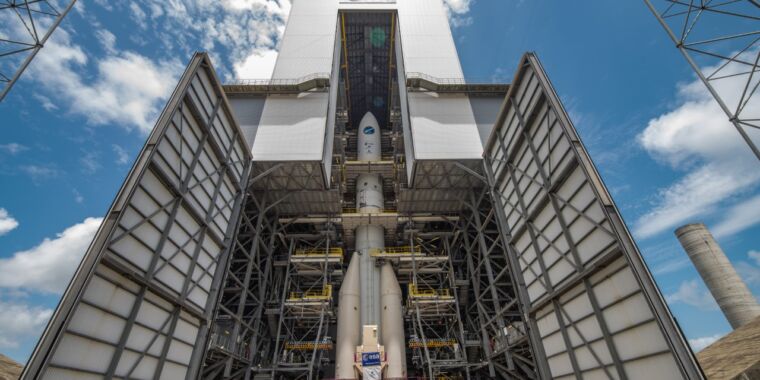

Here below please find the updated schedule for #Ariane6 development. With this, @ESA, @ArianeGroup, @Arianespace and @CNES confirm that the inaugural launch is now targeted for 2024.
After successful tests including completion of a launch chronology of the core stage up to the ignition of the Vulcain thrust chamber on 18 July in Kourou, we will run a short hot-firing test on 29 August.
The following milestone will be the third hot-firing test of the upper stage in Lampoldshausen on 1 September.
A long hot-firing test of the core stage – scheduled for 26 September @EuropeSpacePort – will be open for journalists to attend.
Furthermore, we will organize a detailed briefing after the long hot-firing test of 26 September, when we will also be able to provide a more precise launch period for 2024. Our next regularly scheduled Task Force report to the public is planned for 4 September.
Ariane 6 task force update: great data and results from the hot-fire September tests for #Ariane6 both in French Guiana and Germany. However, an anomaly was detected in the thrust control vector hydraulics when preparing for the next test and the long-duration hot firing test will no longer take place on 3 October as teams investigate the causes. We will come back to you with more updates when available.
ESA don't know anymore how to build a rocket.
Programmatic mistakes and an uninterrupted list of failures.
Since when does finding an issue in a test constitute a failure?ESA don't know anymore how to build a rocket.
Space: Airbus and Safran want more public money to operate Ariane 6
According to corroborating sources, ArianeGroup, owned by Airbus and Safran, is negotiating with the member states of the European Space Agency a very clear reassessment of support for the operation of Ariane 6 due to the consequences of inflation. The manufacturer is asking for €350 million per year, corresponding to an increase of ... 150%.
Ariane 6: first flight in April-May 2024?
Ariane 6 could take off for the first time in the second quarter of 2024. The new European heavy launcher is expected to ramp up rapidly, with ten launches scheduled from 2027.
Ariane 6 should at least have included a modicum of reusability, but once again, I'm not bitter...
Ariane 6 should at least have included a modicum of reusability, but once again, I'm not bitter...
It started already with Ariane 5 replacing the cheaper Ariane 4 but who cares it's the EU subsidies the launches.

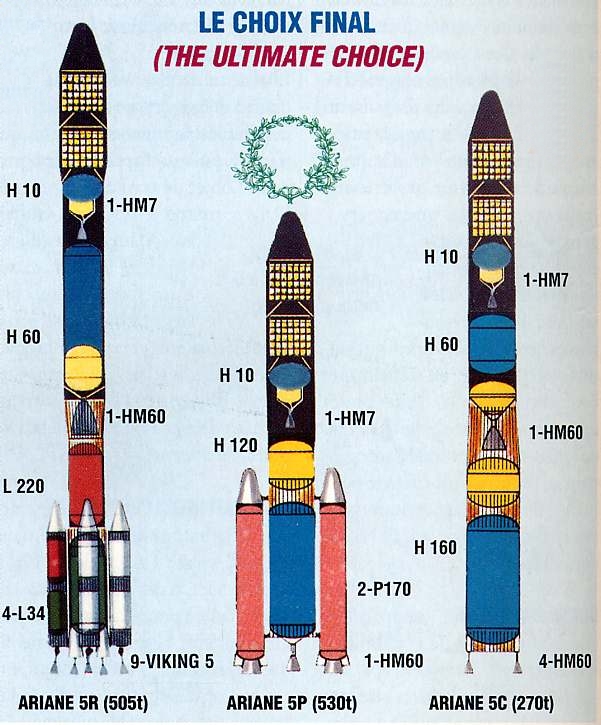

the Ariane 5R and Ariane 5C could fly those mission too (yes Ariane 5R was on Limit for payload.)The reason why the Ariane 4 was replaced is that the satellites it was launching kept getting bigger and bigger, it was no longer up to the task.
Ariane 6 update
In order to optimise the #Ariane6 testing schedule, the test sequence has been inverted. This allows us to anticipate the launch rehearsal test, followed by the long-duration firing test of the main stage Vulcain 2.1 engine, and ultimately reduces any impact on the overall schedule.
*Next milestones*
October: Combined test, launch rehearsal with ignition of the main stage, Kourou, French Guiana
November: Combined test, long-duration firing of the main stage with Vulcain 2.1 engine, Kourou, French Guiana
December: Upper stage firing test, Lampoldshausen, Germany
Read the full update here:
