Why would IEPS be a must, the build track record of the IEP Zumwalts was a disaster, the third and final ship Lyndon B Johnson construction began May 2012 and only sailed to Ingalls for its combat installation early January 2023, the best part of 11 years, one reason quoted for the long build time was hours required for the IEP.asVAL said:
Back to LSC.

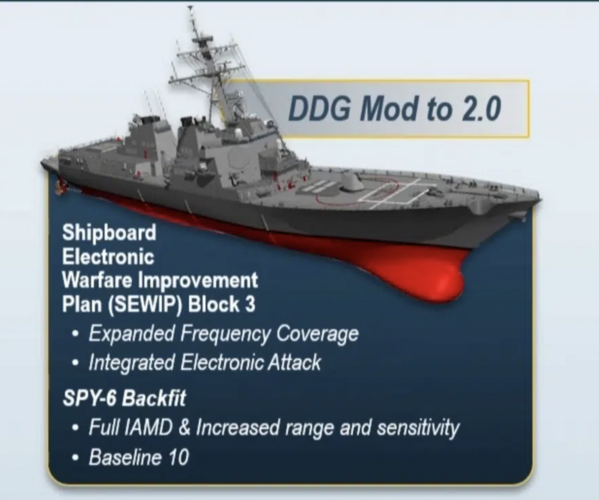

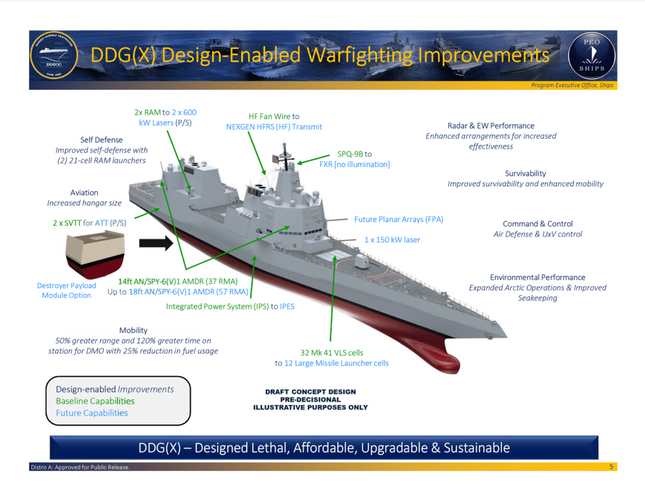

How about building a Flight IIIA that incorporates the CGBL hull mated to a modern propulsion ( IEPS is a must) and the current Flight III combat system? Think: 128 VLS, double RAM and can be upgraded to DEW, AMDR, SLQ-32v7 and a new CIC. How fast could one shipyard switch over to building a larger, albeit only stretched, hull form? It's not an entirely new run, just an upgrade to deal with the obsolecense of the Burke hull design and prepare the USN for DDGX.
If you need additional instantaneous electrical power by far the quickest/cheapest and most economical system to operate are diesel generators and UPS with a DC grid which allows instant synchronization when additional DG bought online and also allows the DGs to operate at its optimal variable speeds for the power needed whereas with an AC grid it requires the generators time to synchronize and the reason why with the Burke the Navy requires two of its AG9140 GTGs to be operating with the spare guzzling fuel all the time, even if the power is not required, so if one fails for any reason instant power available to avoid outages. Other pluses with DC grid it also saves weight/cost/space as it eliminates the big and heavy main switchboards and drive transformers.
